Why Did My App Quote Go From Rs. 3L to Rs. 18L? (Scope Creep Explained)

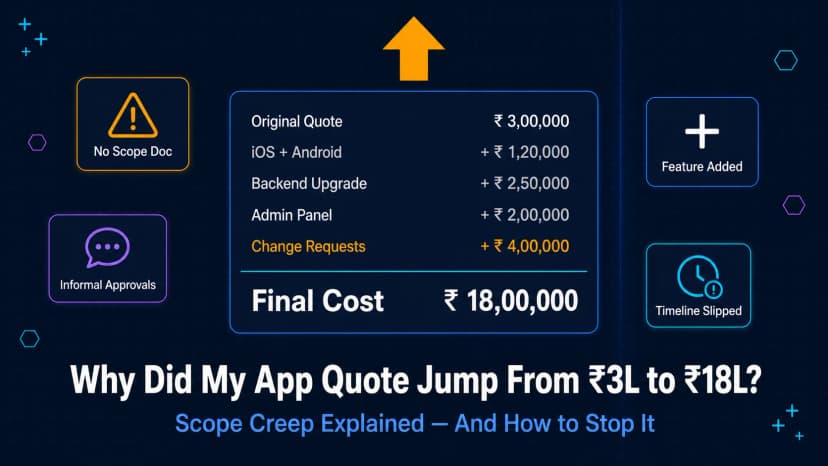

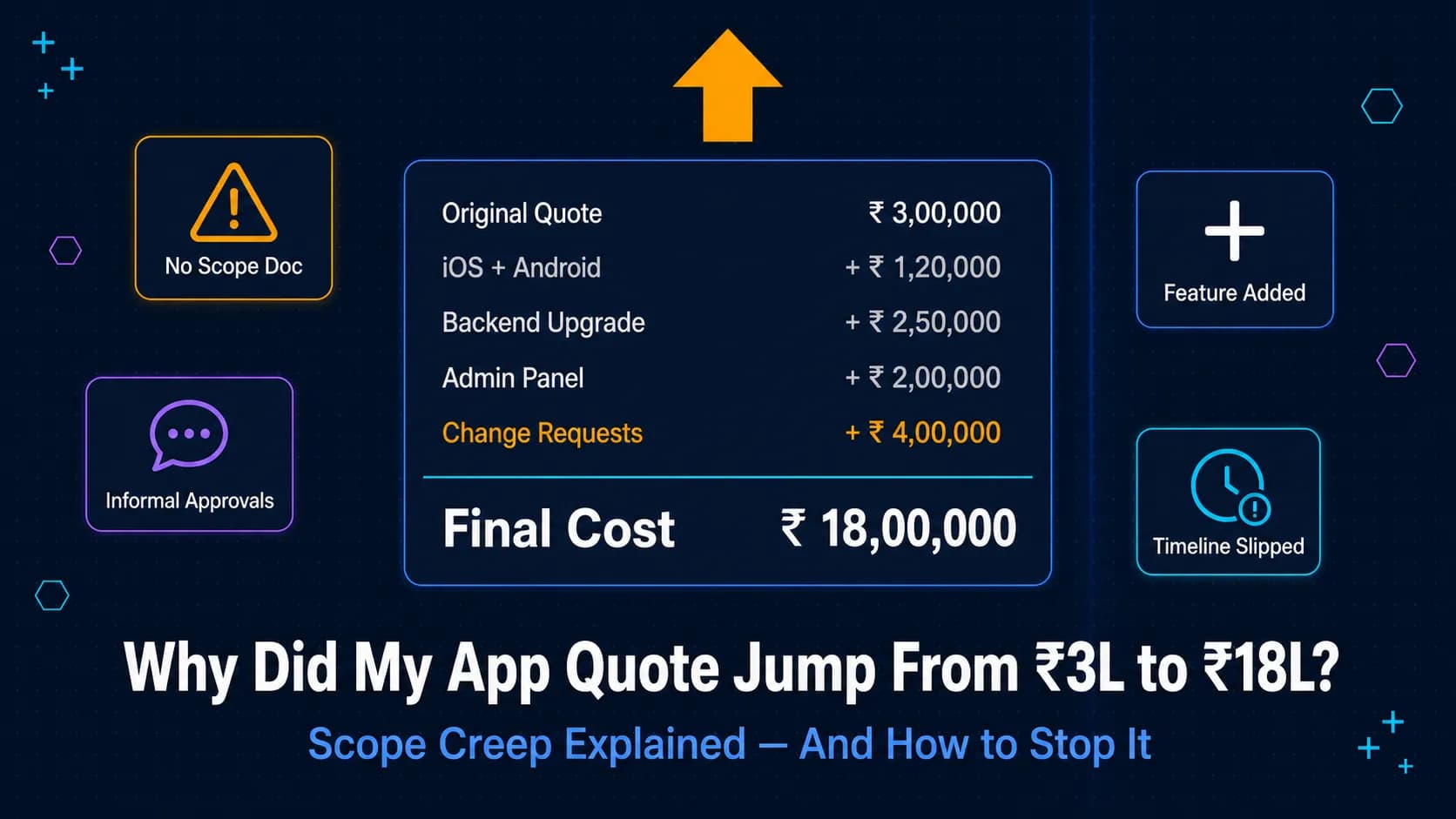

The project started at Rs. 3 lakhs. Somewhere between the first call and the sixth month, it became Rs. 18 lakhs.You are not sure exactly when it happened. Ther

Karan Singh

Karan Singh

Founder

1 May 202612 min read
Why Did My App Quote Go From Rs. 3L to Rs. 18L? (Scope Creep Explained)
All Articles

The project started at Rs. 3 lakhs. Somewhere between the first call and the sixth month, it became Rs. 18 lakhs.

You are not sure exactly when it happened. There was not one dramatic moment where someone called and said "the price has tripled." It crept up. A new feature added here. A small change there. A "this will only take a few days" that turned into three weeks. And then you looked at your total spend and realised you had crossed six times your original number without ever consciously agreeing to it.

If this has happened to you, you are not alone. And you are not naive for letting it happen. Scope creep is one of the most common and most damaging forces in software development worldwide. According to the Project Management Institute, roughly 52% of projects experience some form of scope creep. In India's app development market, where many projects start without a proper specification document, the number is likely higher.

This article explains exactly what app development scope creep is, how it turns a Rs. 3 lakh quote into a Rs. 18 lakh reality, the specific reasons it happens in Indian projects, and how to prevent it before it starts.

What Is Scope Creep? The Real Definition

Scope creep is the gradual, uncontrolled expansion of a project's requirements beyond what was originally agreed, without any corresponding increase in budget or timeline being formally approved.

The word that matters most in that definition is uncontrolled. Adding features to an app is not inherently a problem. Products evolve. Requirements change. Markets shift. The problem is when features are added without anyone formally acknowledging that the scope has changed, agreeing to the additional cost, and adjusting the timeline accordingly.

Scope creep does not usually arrive all at once. It arrives in increments that each seem small and reasonable in the moment.

"Can we add a ratings system? It won't be that complex."

"Actually, let's do WhatsApp login instead of just email."

"The admin panel needs a revenue dashboard too. Can that be part of this?"

"We realised we need a driver version of the app, not just the passenger side."

Each of those requests sounds sensible. Each one, depending on the project, can add weeks of development work and lakhs of rupees to the bill. Collectively, they are why your Rs. 3L quote became Rs. 18L.

How a Quote Goes From Rs. 3L to Rs. 18L: A Real Scenario

Let me walk you through how this happens in practice because it is remarkably consistent across projects.

Month 1: The original brief

A founder describes a cab booking app. Simple concept. A passenger books a ride. A driver accepts. Payment happens. The agency quotes Rs. 3L for a basic Android app with a straightforward booking flow, manual driver assignment, and Razorpay payment integration.

Month 2: The first additions

The founder realises they want both Android and iOS. Reasonable. That adds Rs. 1.2L for the cross-platform build. The quote is now Rs. 4.2L.

They also want a driver app, not just a passenger app. Two separate apps, not one. The agency adds Rs. 1.8L. The quote is now Rs. 6L.

Month 3: The backend reality

Development begins and the team realises that real-time GPS tracking, automated driver dispatch, and live ride status updates require a significantly more robust backend than the original quote assumed. The original quote assumed a basic server. Real-time features need WebSocket infrastructure and a more complex API architecture. Add Rs. 2.5L. Quote: Rs. 8.5L.

Month 4: The admin panel

The founder wants to manage drivers, monitor live rides, view revenue reports, and handle customer complaints. A full operations admin panel. This was never in the original brief. It is also not a small addition. Add Rs. 2L. Quote: Rs. 10.5L.

Month 5: The changes

The payment flow needs to support both cash and UPI in addition to card payments. The notification system needs to handle ride cancelled, driver arriving, and ride completed states separately. The rating system gets added because "users won't trust the platform without it." Each change is approved informally over WhatsApp. No written change orders. No formal timeline adjustments.

Add Rs. 4L across these additions. Quote: Rs. 14.5L.

Month 6: The post-launch requests

The app launches. The founder wants referral codes added. Then promo codes. Then a surge pricing mechanism. "These were always part of the plan," they say. The agency disagrees. There is no written specification from Month 1 to refer to.

Add Rs. 3.5L. Final spend: Rs. 18L.

This is not a horror story. This is Tuesday in Indian app development.

The Six Reasons Scope Creep Happens in India

Understanding the causes is the first step to stopping it. These six reasons account for the overwhelming majority of scope creep in Indian app development projects.

1. No Written Specification Document Before Development Starts

This is the root cause of almost every scope creep situation. When a project starts from a verbal brief or a rough WhatsApp conversation instead of a written feature list, every party in the project operates from their own mental model of what the app is.

The founder imagines the full product. The agency quotes what they understood from the call. The developer builds what they read in the brief. When the app does not match the founder's imagination, the gap gets filled with change requests. Those change requests are scope creep.

A Software Requirements Specification (SRS) document, agreed and signed before development begins, is the single most effective defence against scope creep. It defines exactly what is included and, equally importantly, what is not.

2. Vague Feature Descriptions in the Brief

"User login" means something different to every person who reads it. To one developer, it means email and password. To the founder, it means email, Google login, Facebook login, OTP via SMS, and biometric unlock.

"Admin dashboard" to one agency means a page with a table. To the founder, it means a full analytics suite with revenue charts, driver performance graphs, and customer complaint management.

Vague descriptions allow assumptions to fill the gap. Assumptions become the source of disputes and change requests.

Every feature in a brief needs to describe the specific user actions, the specific outcome, and the specific edge cases. "User can log in using email and OTP via SMS. Google OAuth optional in Phase 2." That is a clear feature. "User login" is not.

3. Informal Change Approval Over WhatsApp

This is specific to Indian app development projects and it is where enormous amounts of scope creep originate.

A founder sends a message: "Can we also add a chat feature so passengers and drivers can communicate?" The developer says "sure, we can do that." No cost is discussed. No timeline impact is agreed. No written change order is signed.

Three weeks later, the chat feature has added significant development time. The agency adds it to the invoice. The founder is surprised. There is no paper trail to resolve the dispute.

Verbal or WhatsApp approvals for changes are not scope approvals. Every change to the project scope needs a written change order: what is being added, what it costs, how it affects the timeline, and a signature from the founder before work begins.

Our mobile app development process uses formal change order documentation for every scope modification. It protects both parties and prevents the end-of-project invoice shock that destroys client-agency relationships.

4. Competitor Features Added Mid-Project

A founder discovers a competitor's app mid-development. The competitor has a feature they had not thought of. Now that feature needs to be in the app too. This is one of the most common sources of mid-project scope expansion.

The problem is not that the idea is bad. It might be a great idea. The problem is that it was not in the original scope, the original timeline was not built around it, and adding it mid-development is significantly more expensive than planning for it from the start.

Features added during active development cost roughly two to three times more than the same features planned from the beginning. The codebase has already been architected without them. Retrofitting a feature the architecture did not anticipate means rework, not just new work.

5. No Separation Between Phase 1 and Phase 2

Many Indian founders go into app development with a full product vision and no structure for staging that vision across phases. Everything feels essential. The MVP never gets agreed. Development begins on the full product.

Midway through, budget runs out or timelines slip because the scope was always too large for the budget. The project gets cut short and delivers an incomplete version of everything rather than a complete version of the core product.

A clearly defined Phase 1 (the MVP, the minimum needed to launch and validate) and a documented Phase 2 backlog (everything else) is the structural solution. Phase 1 ships on time and on budget. Phase 2 starts when Phase 1 has been validated.

6. The Time and Materials Contract Problem

On a fixed-price contract, scope creep creates a dispute: the agency says you asked for more than they quoted, the founder says this was always part of the plan. At least both parties feel the tension and there is usually a paper trail to resolve it.

On a time-and-materials contract, scope creep is invisible. Every hour worked is billed. Features get added. Time gets spent. The invoice grows. Nobody formally acknowledges that the scope has expanded because nobody has to. The founder just sees the monthly invoice increasing and does not always understand why.

Fixed-price contracts are not suitable for every project. But if your project has a well-defined scope and a fixed budget, a fixed-price contract is the structure that makes scope creep visible and therefore manageable.

How to Prevent Scope Creep Before It Starts

Prevention is infinitely cheaper than remediation. Here is a practical system that works.

Get everything in writing before signing anything. Every feature. Every user role. Every integration. Every screen. A written specification document agreed by both parties before work begins is the contract within the contract. When a dispute arises, you go back to the document. Before we scope any project, we help founders document exactly this. See what a realistic brief looks like here.

Define Phase 1 explicitly and protect it. Agree on the MVP scope, document it as Phase 1, and do not allow Phase 2 features to enter Phase 1 development without a formal scope change. The moment a Phase 2 feature gets pulled into Phase 1 without acknowledgement, scope creep has already started.

Use written change orders for every modification. No WhatsApp approvals. No informal "yes, let's do that" over a call. Every change to scope, no matter how small, needs a written change order with cost impact, timeline impact, and a signature. This is not bureaucratic. It is the only reliable way to track what was agreed and what was not.

Hold a scope review at the end of every development phase. Before moving from design to development, review the scope document together. Before moving from development to QA, review it again. Changes are far cheaper to catch at a review point than to discover at invoice time.

Set a change budget. Accept that some changes will happen. Budget for them explicitly: typically 10 to 15% of the project value held in reserve for legitimate scope changes that arise during development. When the change budget is exhausted, new additions move to Phase 2.

If you want a project that starts with a proper written specification and a fixed-price contract with formal change management built in, share your brief with us and we will scope it that way from day one.

What to Do If Scope Creep Has Already Happened

If you are mid-project and the cost has already grown significantly, here is the honest recovery process.

First, call a formal scope review. Sit down with your agency and go through every feature currently in development. Separate what was in the original brief from what was added. This conversation is uncomfortable. It is also necessary.

Second, categorise every addition. Features that are genuinely essential for launch stay in Phase 1. Features that are desirable but not critical move to Phase 2. Features that were added in response to impulse or competitor comparison get removed entirely or rescheduled.

Third, get a revised fixed-price quote for the agreed Phase 1 scope. Now that the scope is defined, lock it in writing. No more informal additions.

Fourth, document Phase 2 for after launch. Do not abandon the features that got cut. Write them down, prioritise them, and build them after the product launches and generates revenue or validates the model.

Scope creep that is caught at month four is recoverable. Scope creep that runs unchecked for twelve months usually ends with a product that is over budget, behind schedule, and still incomplete.


Karan Singh is the Founder of Matply Infotech, a mobile app and software development agency in Jaipur with over 10 years of experience delivering fixed-scope, fixed-price app projects for Indian founders and businesses.
